What is the Say-Do Ratio in Profit.co, and how does it help measure business outcomes?
Category: OKRs
Profit.co offers the option to measure progress using the Say-Do Ratio, allowing organizations to track commitments against actual achievements with precision.
What is the Say-Do Ratio?
The Say-Do Ratio is a business value measurement (BVM) methodology that compares what was promised/committed (“say”) versus what was actually delivered (“do”).
- Say → The plan, commitment, or the expected progress you declare at a certain point.
- Do → The actual achievement or progress delivered at that point.
Why this feature?
- Holds teams responsible for fulfilling their commitments, not just showing progress.
- Eliminates inflated reporting by discarding partial completions.
- Keeps focus on actual business value delivered, not interim milestones.
- Adjustable thresholds allow you to define what counts as “done” (e.g., 90% or 100%).
- Ensures reporting aligns across departments by standardizing measurement.
Step 1
How to Enable the Say-Do Ratio?

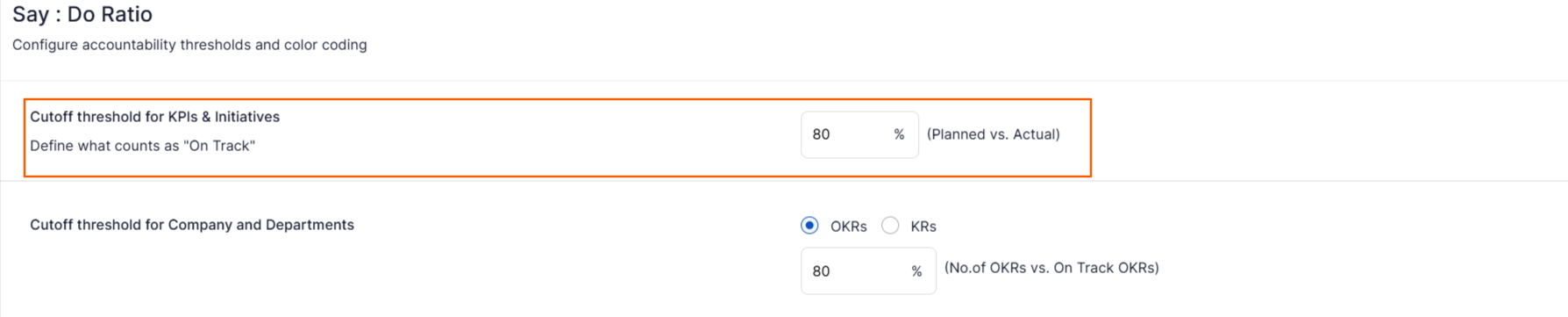

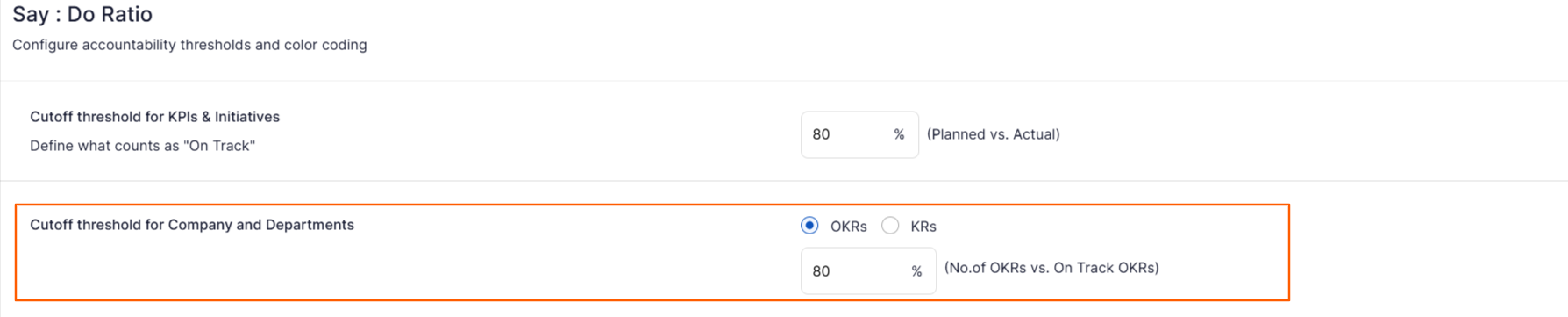

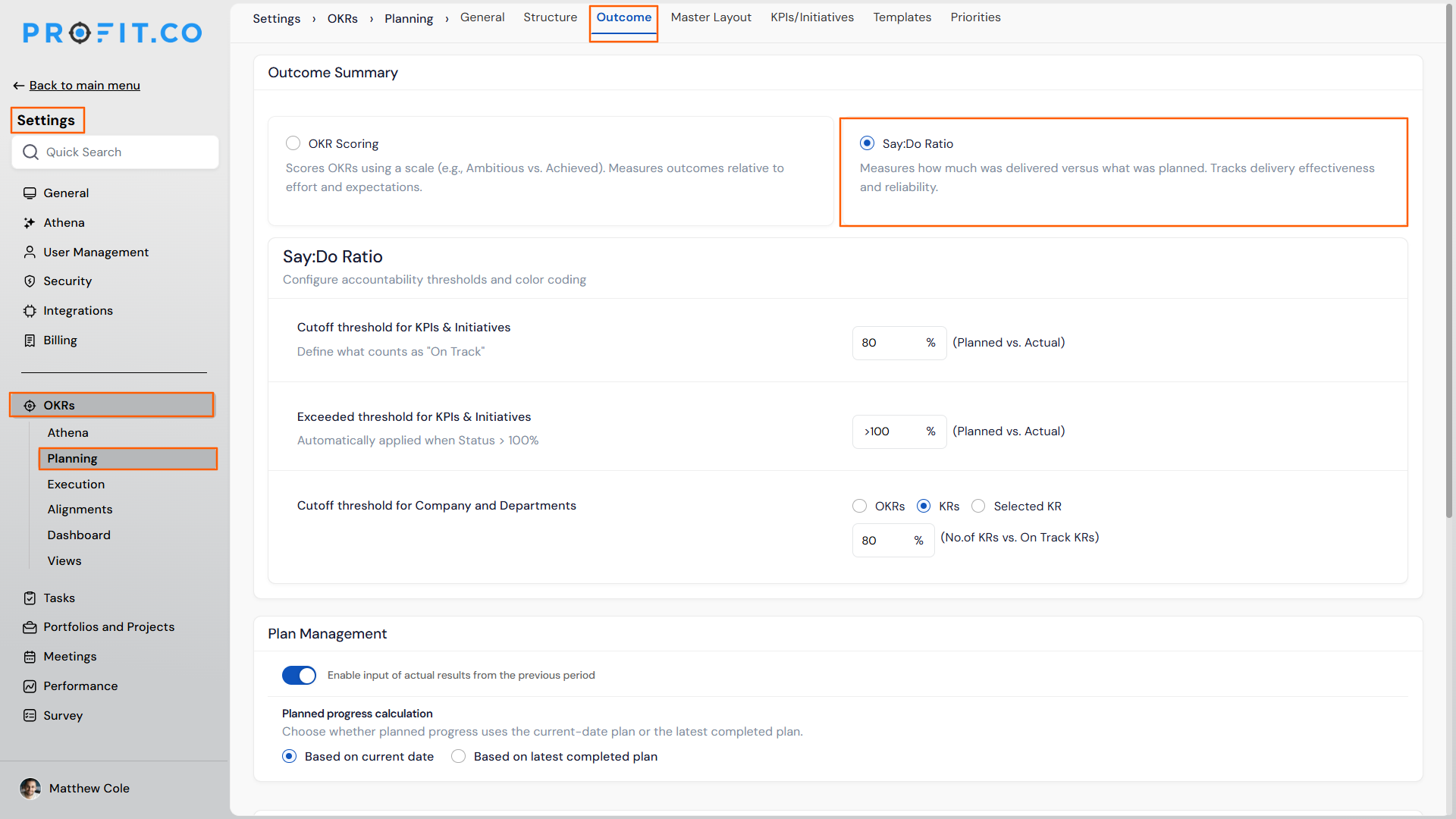

Navigate to Settings → OKRs → Authoring from the left navigation panel. On the Authoring page, select the Outcomes tab. Under Outcomes, enable the option Say-Do Ratio.
Once enabled, the system evaluates OKRs using the Say-Do methodology, replacing standard progress-based scoring.

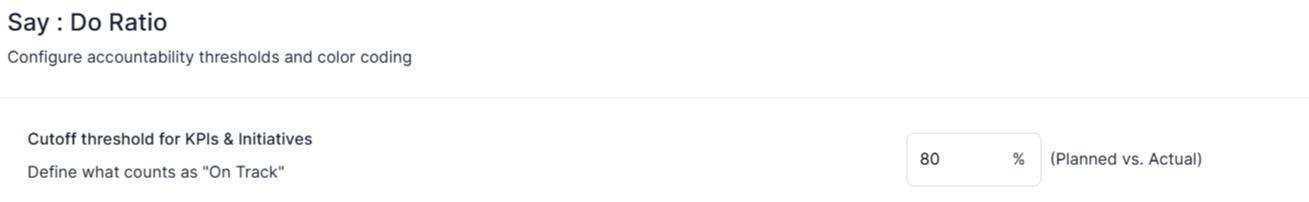

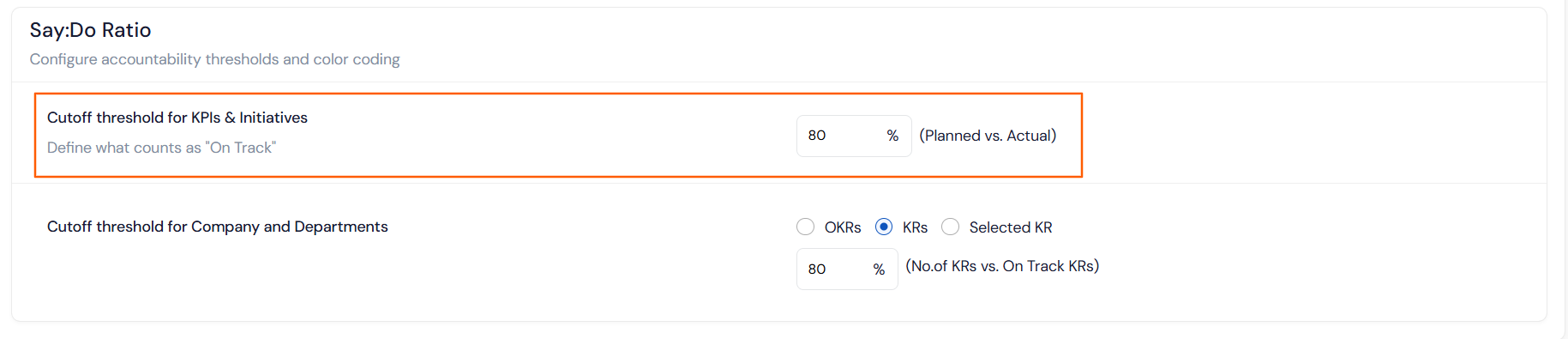

Cutoff for KPIs & Initiatives – Set a target percentage (e.g., 80%) to determine when a KPI or initiative is considered successfully delivered.

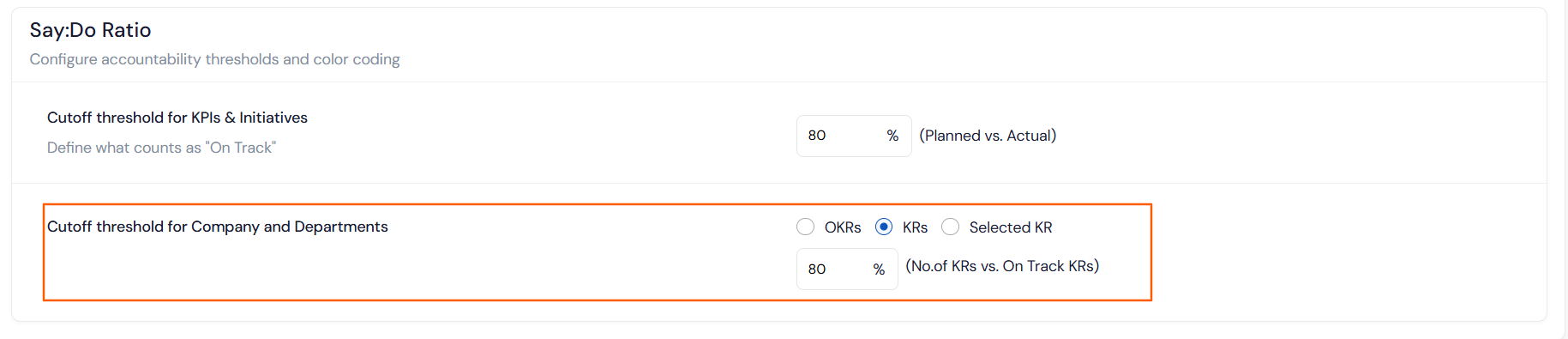

Cutoff for Company and Department OKRs/KRs – Define what portion (e.g., 80%) of total OKRs or KRs must be on track to meet performance standards.

This method supports accountability by tracking actual outcomes against initial commitments.
Note: The Say-Do Ratio supports only three status types: Not Started, On Track, and In Trouble.

Step 2

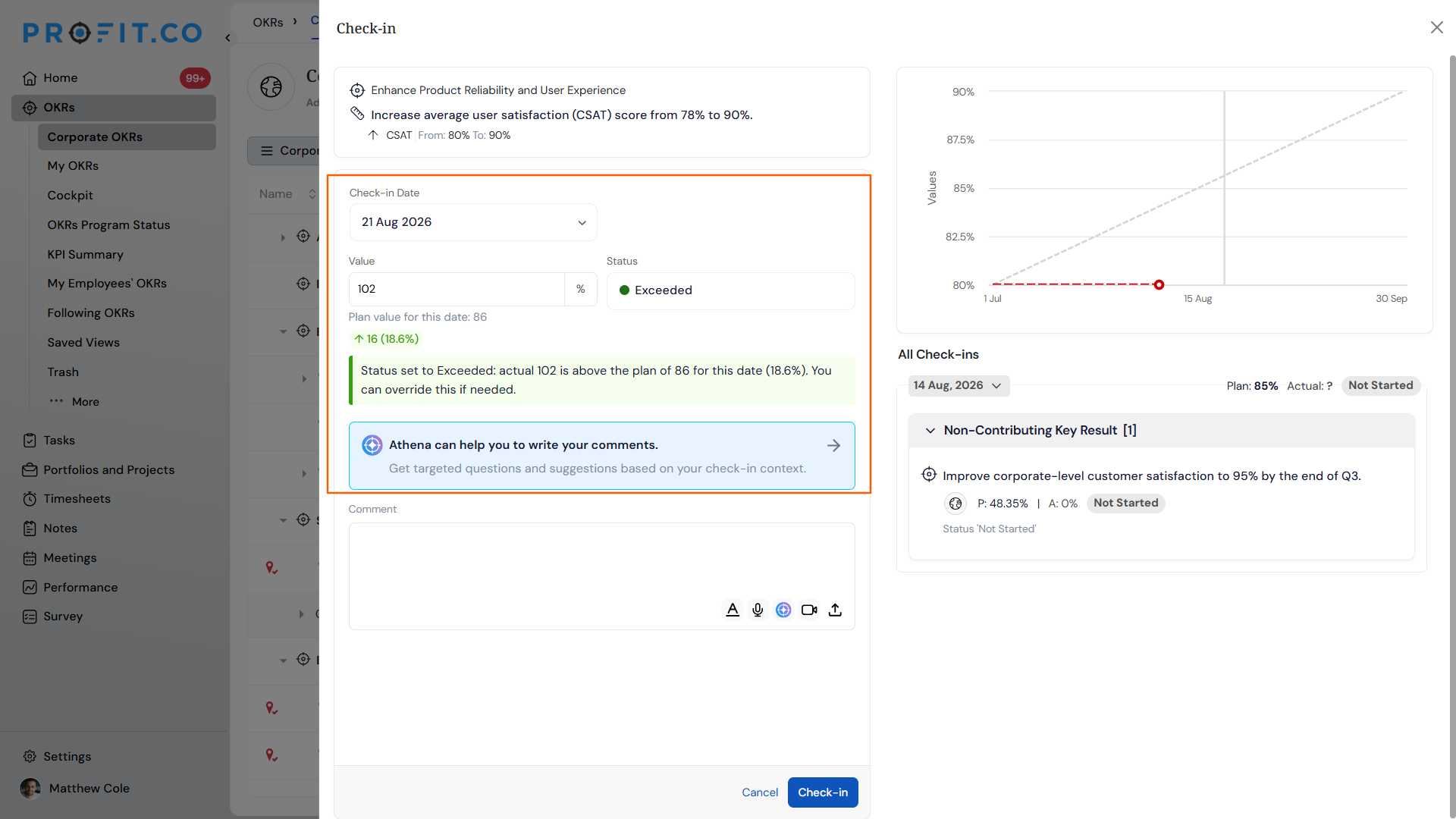

Performing a Check-In with Say-Do Ratio

- If you set the cutoff threshold for KPIs or Initiatives at 80%, the system considers them On Track only when progress is 80% or above.
- If the progress is below 80% (e.g., 79%), the system treats it as Not Started.
Example:
- Key Result: Revamp 30 existing YouTube videos with the latest features
- Target Period: Q3 (July–September)
- Check-in Frequency: Every Friday

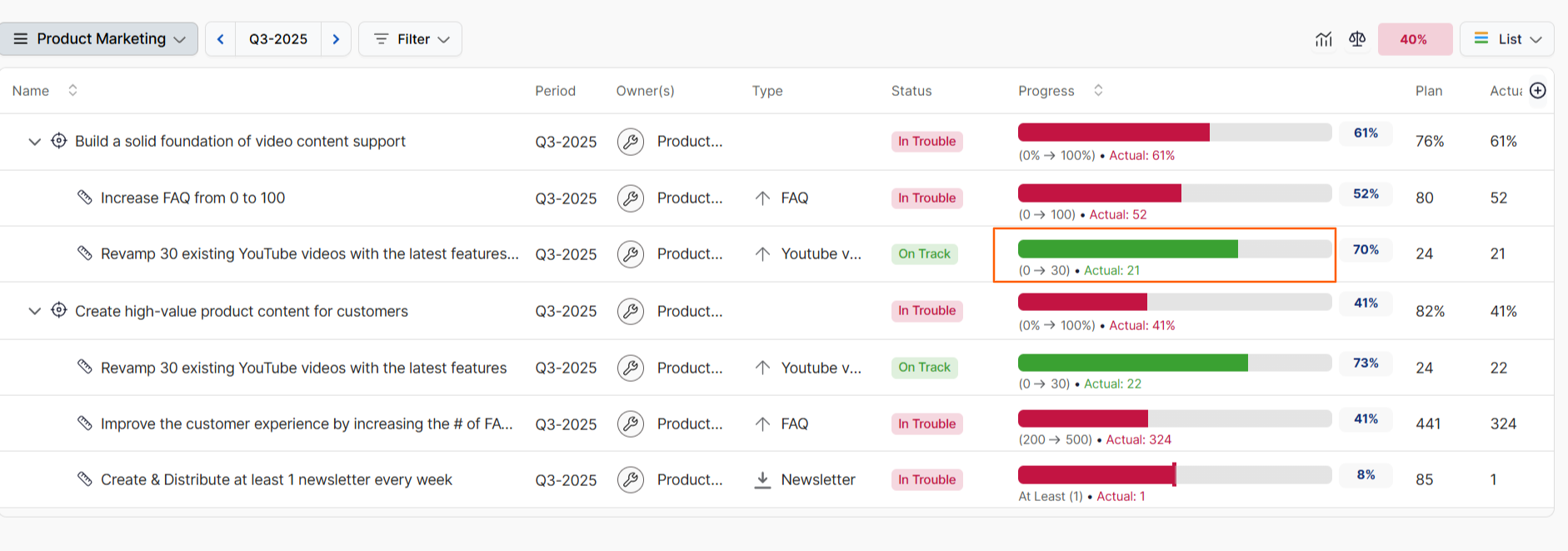

On September 12, the planned progress is 24, and the actual progress is 21.

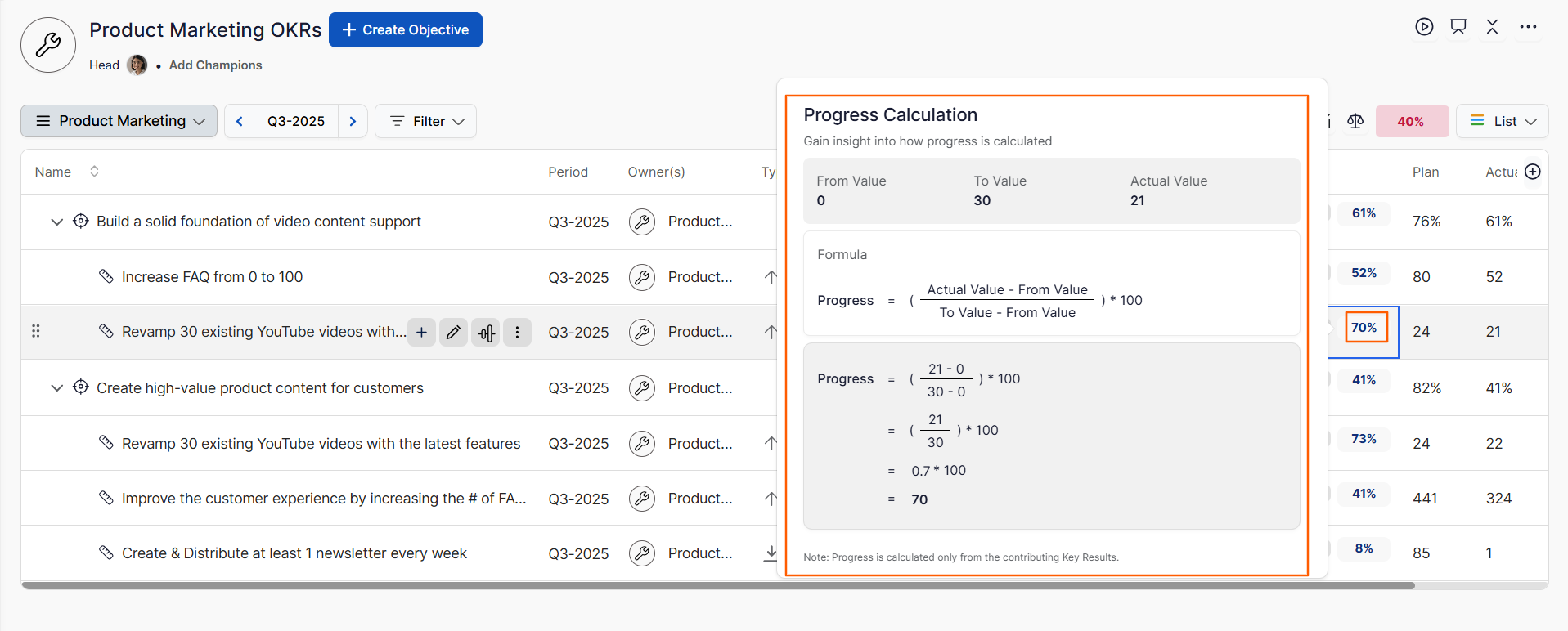

Progress calculation:

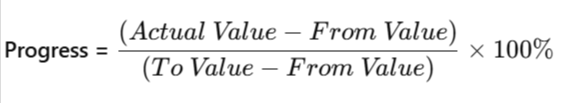

Progress =(24-0/30-0)*100 Progress = 70

Status calculation:

Status=24/22×100
Status = 92%

Since the Status is 92%, it meets the cutoff for KPIs & Initiatives and is marked as On Track.
How is the Overall Objective Progress Calculated?
The system evaluates all Key Results under the Objective against the defined cutoff thresholds.
- Only those KRs meeting or exceeding the threshold are considered On Track.

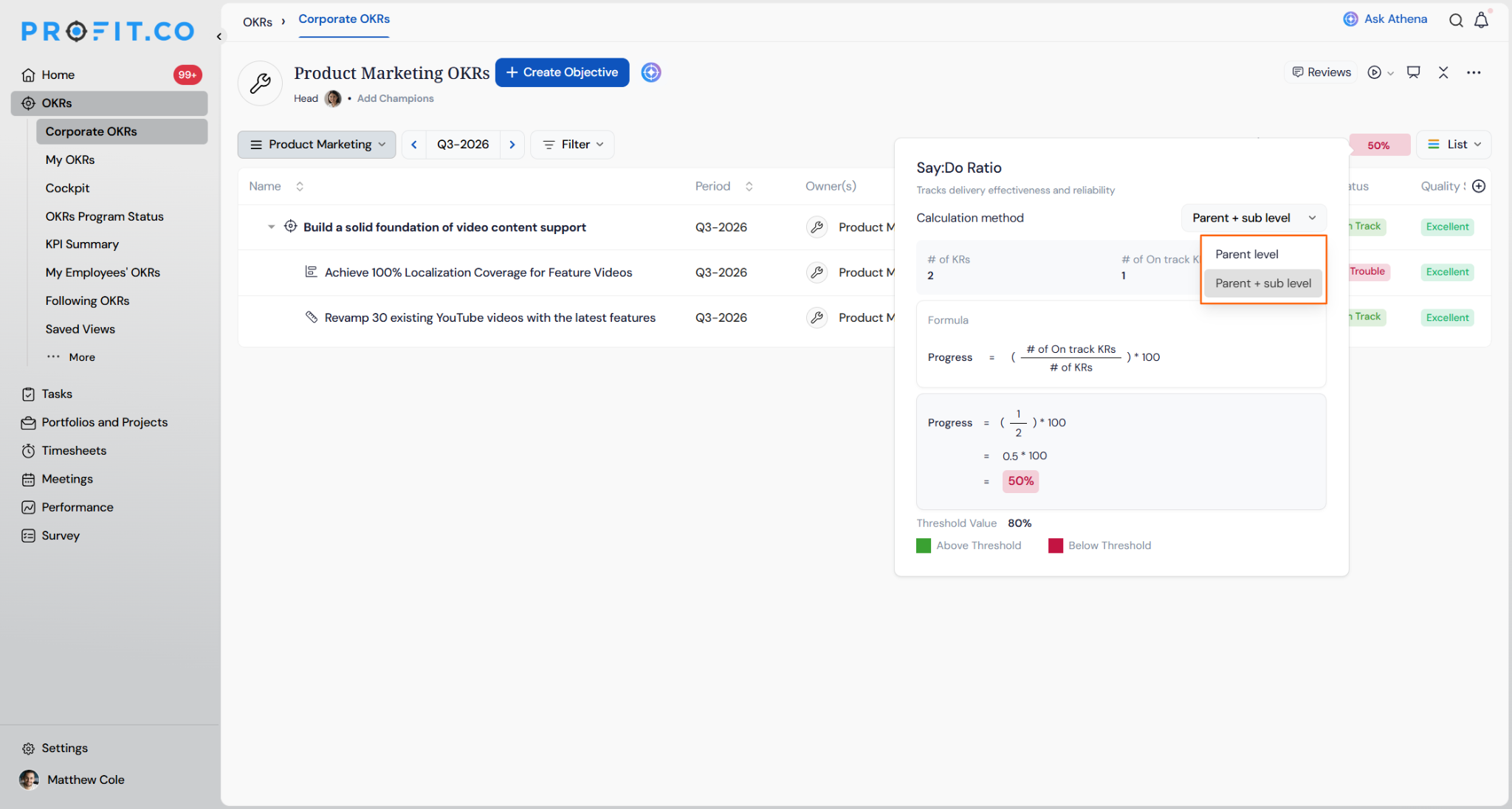

- The Objective’s overall SU Ratio is then calculated as:
(Number of KRs On Track ÷ Total Number of KRs) × 100
