5 min read ·

How to Set Up the Resource Allocation Model in Profit.co?

The Resource Allocation Model in Profit.co controls how the Capacity Workbench plans each resource’s capacity, either from task estimates or from project commitments.

What is the Resource Allocation Model in Profit.co?

The Resource Allocation Model is a PPM setting that decides how the Capacity Workbench calculates a resource’s allocation. You can plan capacity from the hours estimated on tasks, or from the percentage of time a resource commits to a project over its duration.

What are the resource allocation models available in Profit.co?

Profit.co offers two resource allocation models:

Model How capacity is planned Best suited for
Task-driven allocation (default) From task estimates (Original Estimate hours) Teams that plan and track work at the task level
Commitment-driven allocation From the project Allocation % and Duration Teams that commit a share of a person’s time to a project before tasks are planned

How does task-driven allocation work?

Task-driven allocation plans capacity from the hours estimated on each task. The project manager sets the Original Estimate for a task, and the assignee logs their hours through Time Tracking. The Capacity Workbench then shows the allocated and utilized time for that resource.

Example: A project manager sets an Original Estimate of 5 hours for a task. The assignee logs 3 hours against it. The Capacity Workbench shows 5 hours allocated and 3 hours utilized for that resource.

How does commitment-driven allocation work?

Commitment-driven allocation plans capacity from the share of working time a resource commits to a project. You set an Allocation % and a Duration for each project, and Profit.co calculates the hours the resource should contribute in each period.

Example:

Input Value
Resource’s monthly working hours 192 hours (48 hours per week)
Allocation % for the project 40%
Project duration 2 months
Hours the resource contributes per month 192 × 40% = 76.8 hours
Hours the resource contributes per week 48 × 40% = 19.2 hours

How to set up the Resource Allocation Model in Profit.co?

Follow these steps to choose the allocation model for your organization:

Step 1

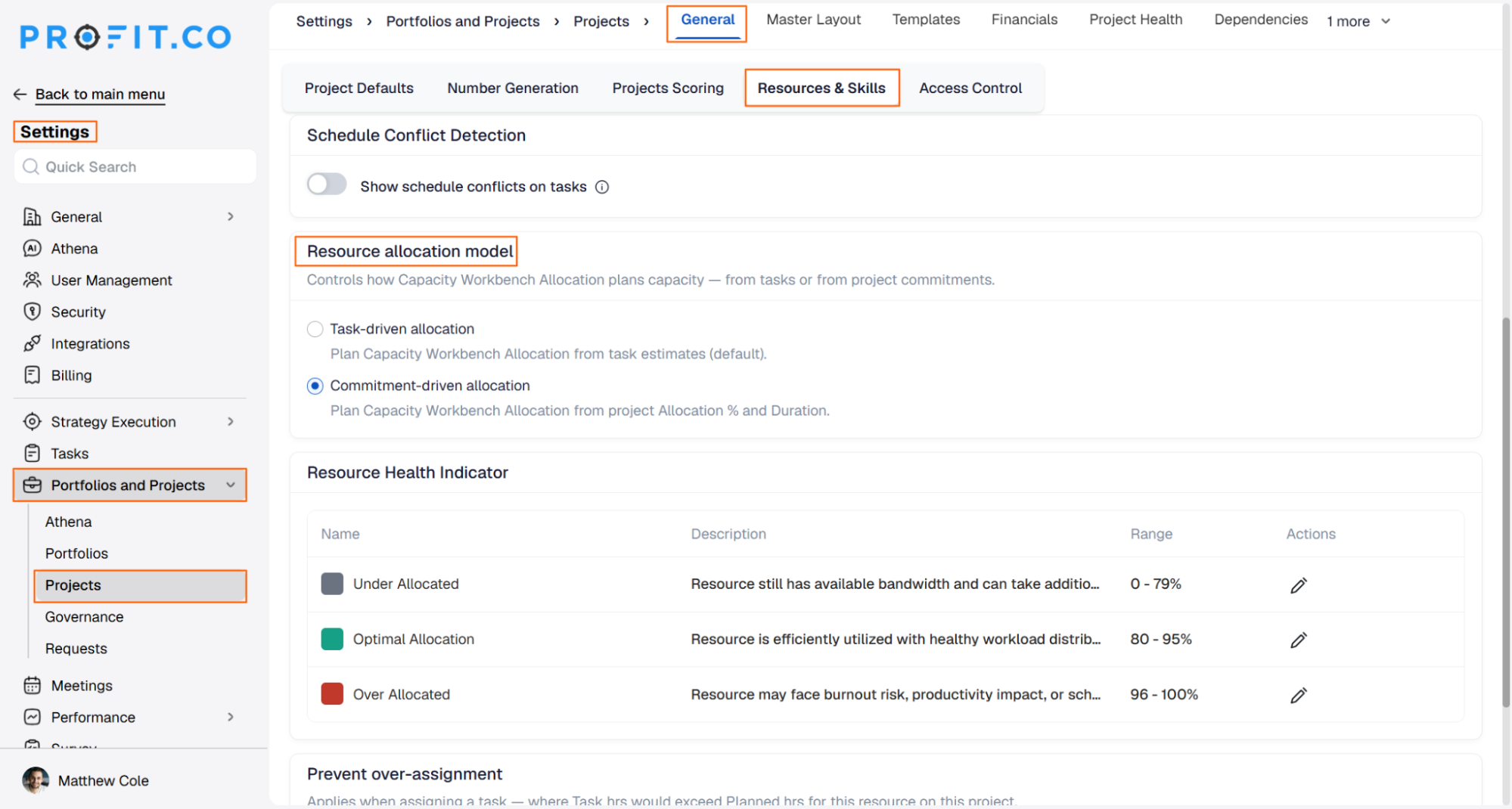

  • Navigate to Settings → Portfolios and Projects → Projects from the left navigation panel.
  • On the General page, switch to the Resources & Skills tab.
  • Scroll down to the Resource allocation model section.
  • Select Task-driven allocation to plan from task estimates, or Commitment-driven allocation to plan from project Allocation % and Duration.

How to use task-driven allocation in Profit.co?

Step 1

  • Open the task inside the project.

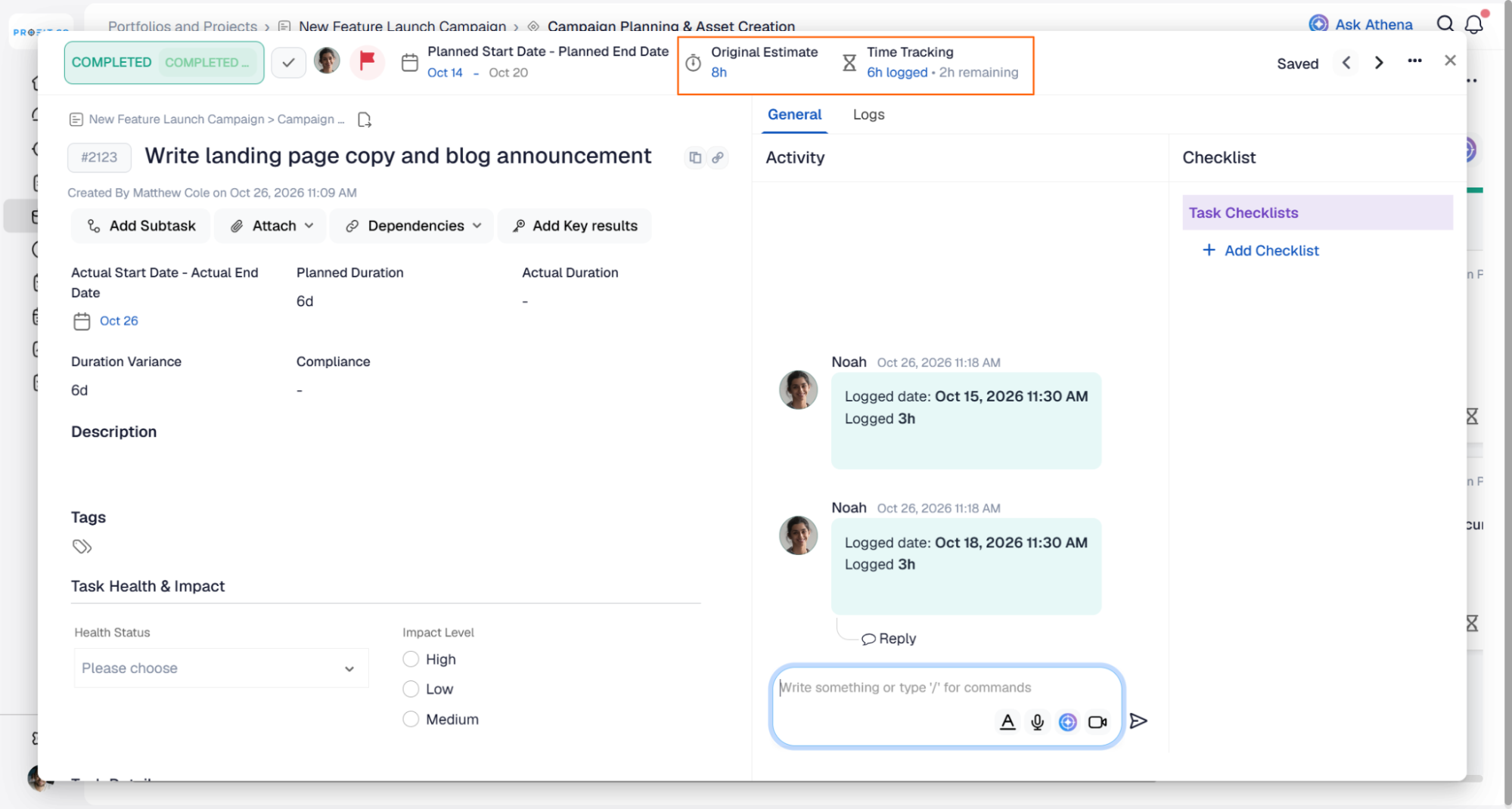

  • Click Original Estimate and enter the planned hours (for example, 5 hours).
  • The task assignee clicks Time Tracking and logs the hours worked (for example, 3 hours).

Step 2

  • Navigate to Portfolios and Projects → Resources → Capacity Workbench.

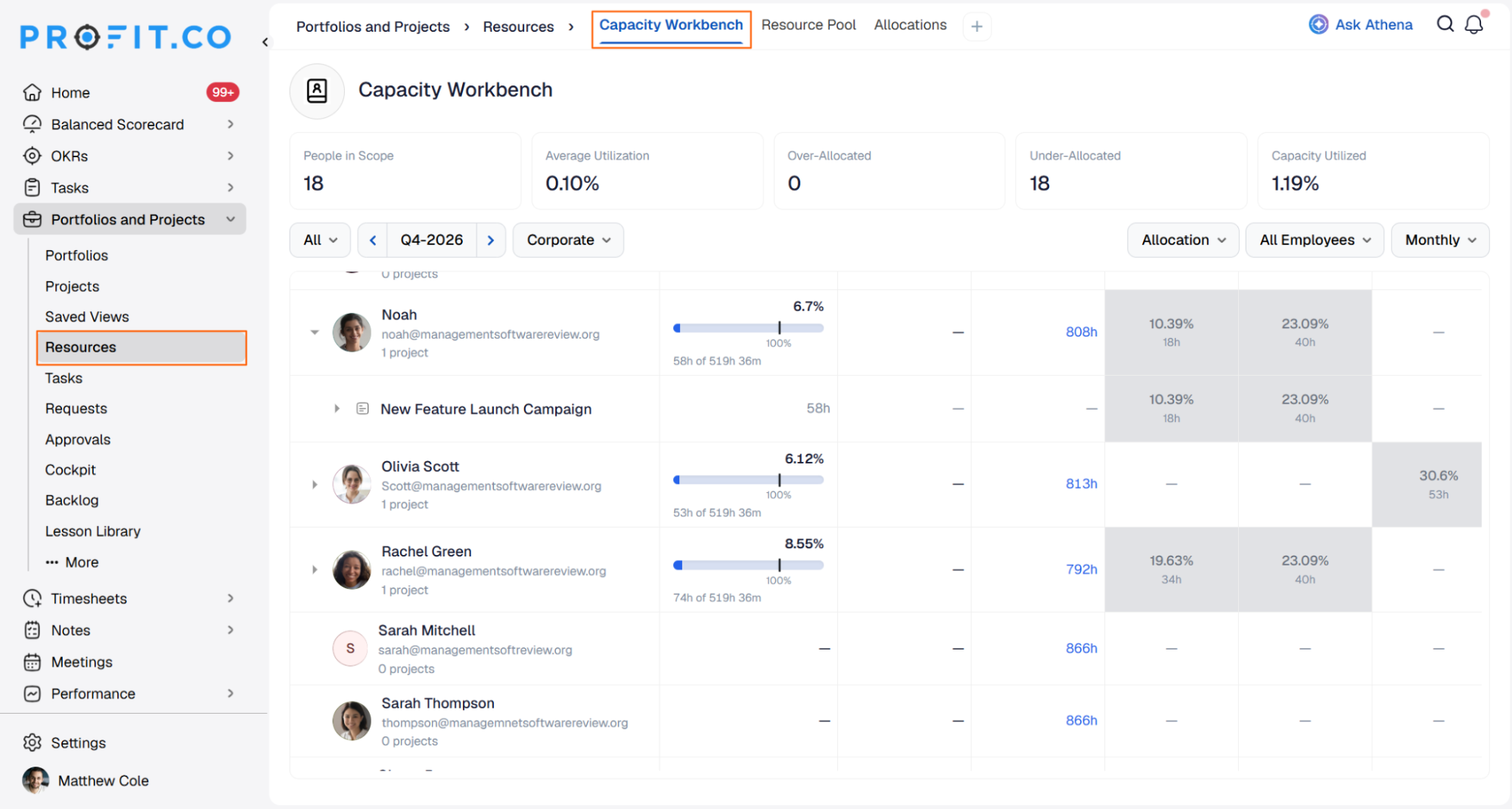

  • Expand a resource to see the allocated and utilized hours for each project and task.

How to use commitment-driven allocation in Profit.co?

Step 1

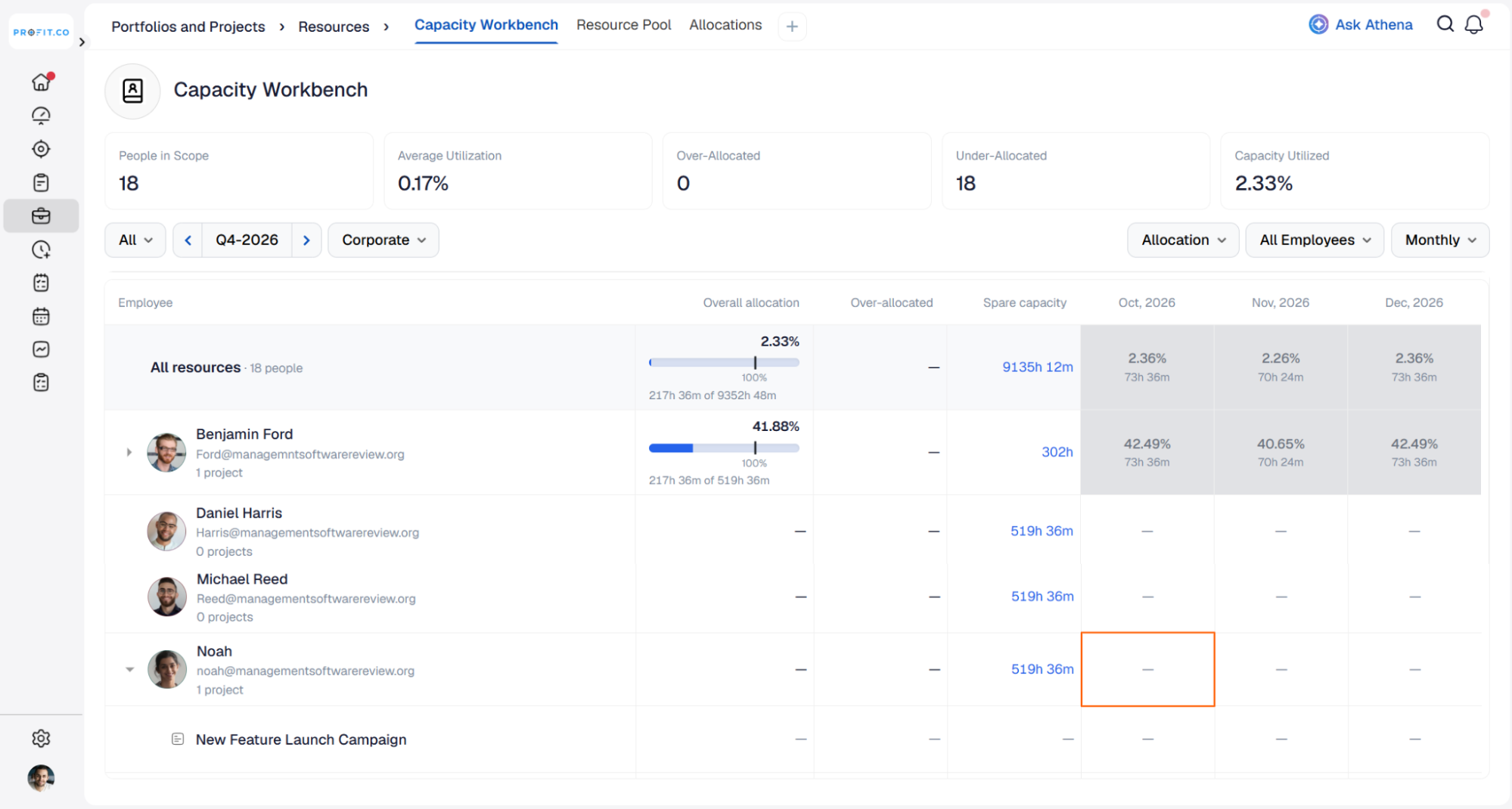

  • Navigate to Portfolios and Projects → Resources → Capacity Workbench.

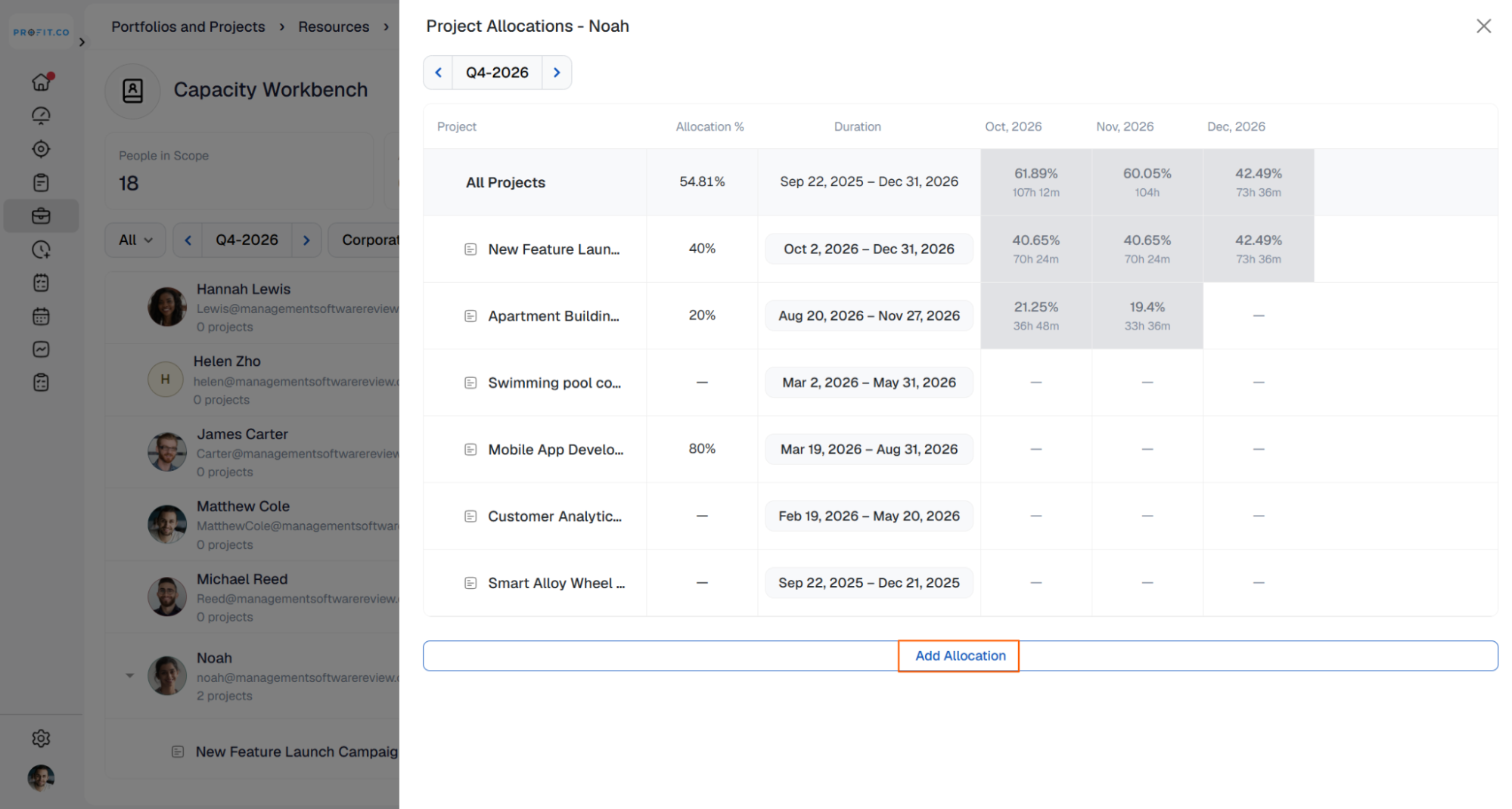

  • Select a resource. The Project Allocations panel opens with the list of that resource’s projects, their Allocation %, and Duration.
  • Click the Allocation % cell for the project.
  • Enter the percentage of the resource’s working hours to commit to that project (for example, 40%).

Step 3

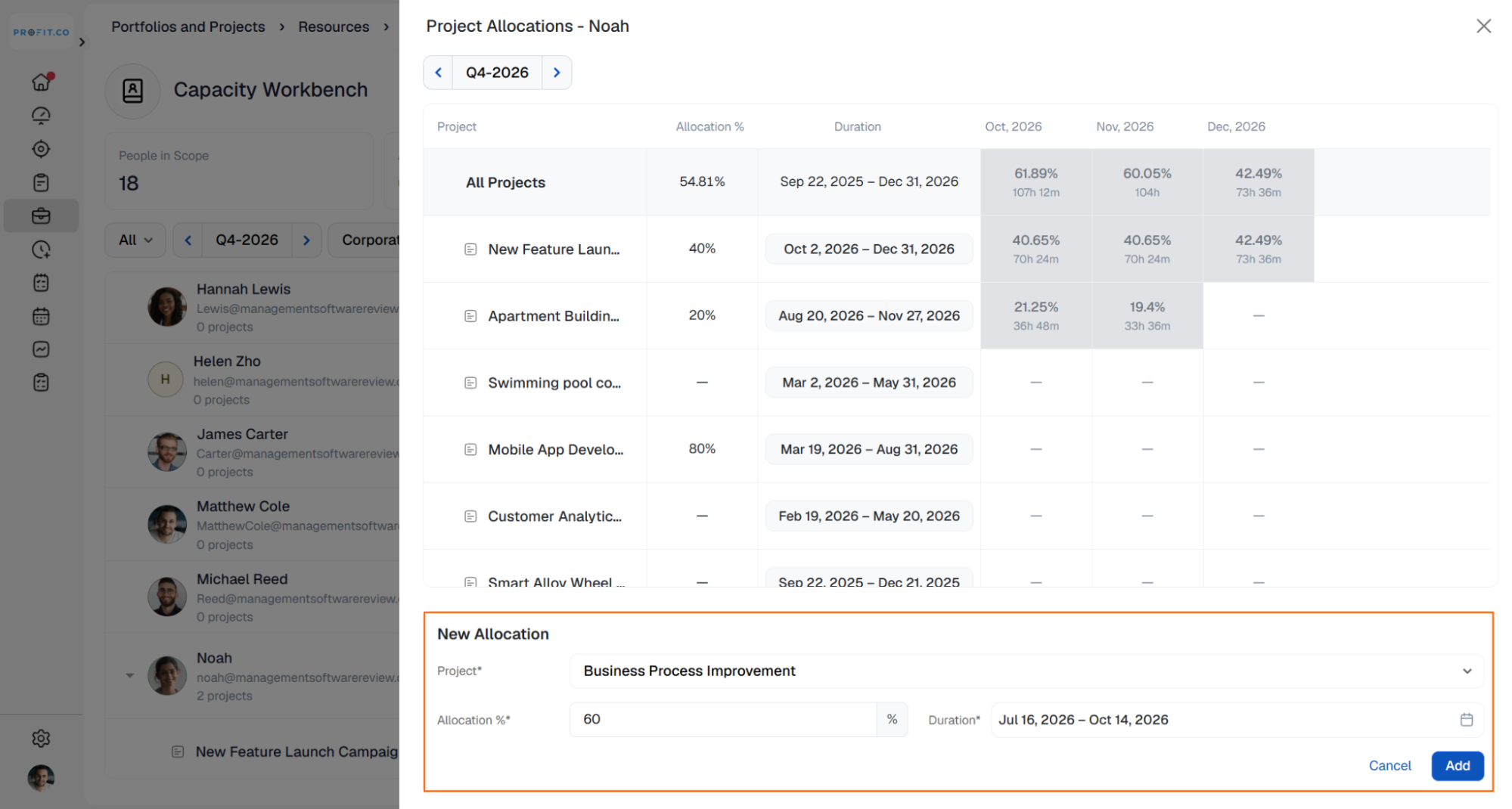

  • Click Add Allocation at the bottom of the panel to add a project the resource isn’t yet associated with.
  • In the New Allocation section, choose the Project, enter the Allocation %, and set the Duration.
  • Click Add.

Best practices for choosing a resource allocation model

  • Use task-driven allocation when your projects are broken into tasks with reliable hour estimates.
  • Use commitment-driven allocation when you staff people to projects by percentage before detailed task planning begins.
  • Keep the total Allocation % across a resource’s projects within their available capacity to avoid over-allocation.
  • Review the Capacity Workbench regularly to spot under-allocated and over-allocated resources early.

Related Questions

Frequently Asked Questions

Q1. Which resource allocation model is the default in Profit.co?

Task-driven allocation is the default model. It plans Capacity Workbench allocation from task estimates.

Q2. Where do I change the resource allocation model in Profit.co?

Go to Settings → Portfolios and Projects → Projects, open the Resources & Skills tab on the General page, and choose a model under Resource allocation model.

Q3. Can I allocate a resource to a project they are not part of yet?

Yes. In commitment-driven allocation, open the resource in the Capacity Workbench, click Add Allocation, and choose the project, Allocation %, and Duration.
